Overdosaging concrete water reducers (especially Polycarboxylate Ether or PCE superplasticizers) leads to severe segregation, excessive bleeding, extreme setting retardation (up to several days), and a drastic drop in early compressive strength. In emergency scenarios on site, over-dosaged concrete can be salvaged by re-batching with dry cement and aggregates (to dilute the admixture concentration), adding concrete setting accelerators (such as calcium formate) to kickstart hydration, or using defoaming agents to eliminate excessive entrained air.
Concrete admixtures are designed to work within a highly precise chemical equilibrium. An accidental overdose typically stems from:
Calibration Errors: Failure to regularly calibrate the liquid dispensing pumps at the concrete batching plant.
Improper Site Adjustments: Construction personnel arbitrarily adding extra superplasticizer directly into the transit mixer truck to restore slump, without calculating the actual moisture content or mixing ratio.
Double-Dosing: Poor communication during shift changes at the batching plant, leading to the same batch being dosed twice.
When high-range water reducers (HRWRAs) are overdosed, the cement particles experience excessive electrostatic repulsion and steric hindrance. This destroys the cohesive structure of the paste. The coarse aggregates sink to the bottom under gravity, while water and cement slurry float to the top, causing massive bleeding and a structural imbalance in the concrete.
Water reducers (especially retarding-type PCEs) slow down the initial hydration of tricalcium aluminate (C3A) and tricalcium silicate (C3S). While a normal dose retards setting by 2 to 4 hours, an overdose of >= 2.0% can delay setting for 24 to 72 hours, or even indefinitely in cold weather.
Although a mild overdose with proper curing might eventually achieve the design strength after 28 days, a severe overdose ruins the mechanical properties. This is especially true if the water reducer has built-in air-entraining agents: every 1% increase in entrained air decreases the concrete's compressive strength by approximately 5%.
As the excess bleeding water evaporates from the surface, it causes rapid volume contraction, leading to extensive plastic shrinkage cracks and a weak, powdery surface crust.
Before discharge, a simple field inspection can prevent a structural disaster:
The Slump Flow Test: If the concrete spreads like water, showing a separation ring (halo) of cement paste around the outer edges, it is severely segregated.
Visual Inspection in the Truck: If the concrete inside the drum produces a sloshing, metallic clatter instead of a sticky, viscous sound, it has been over-dispersed.

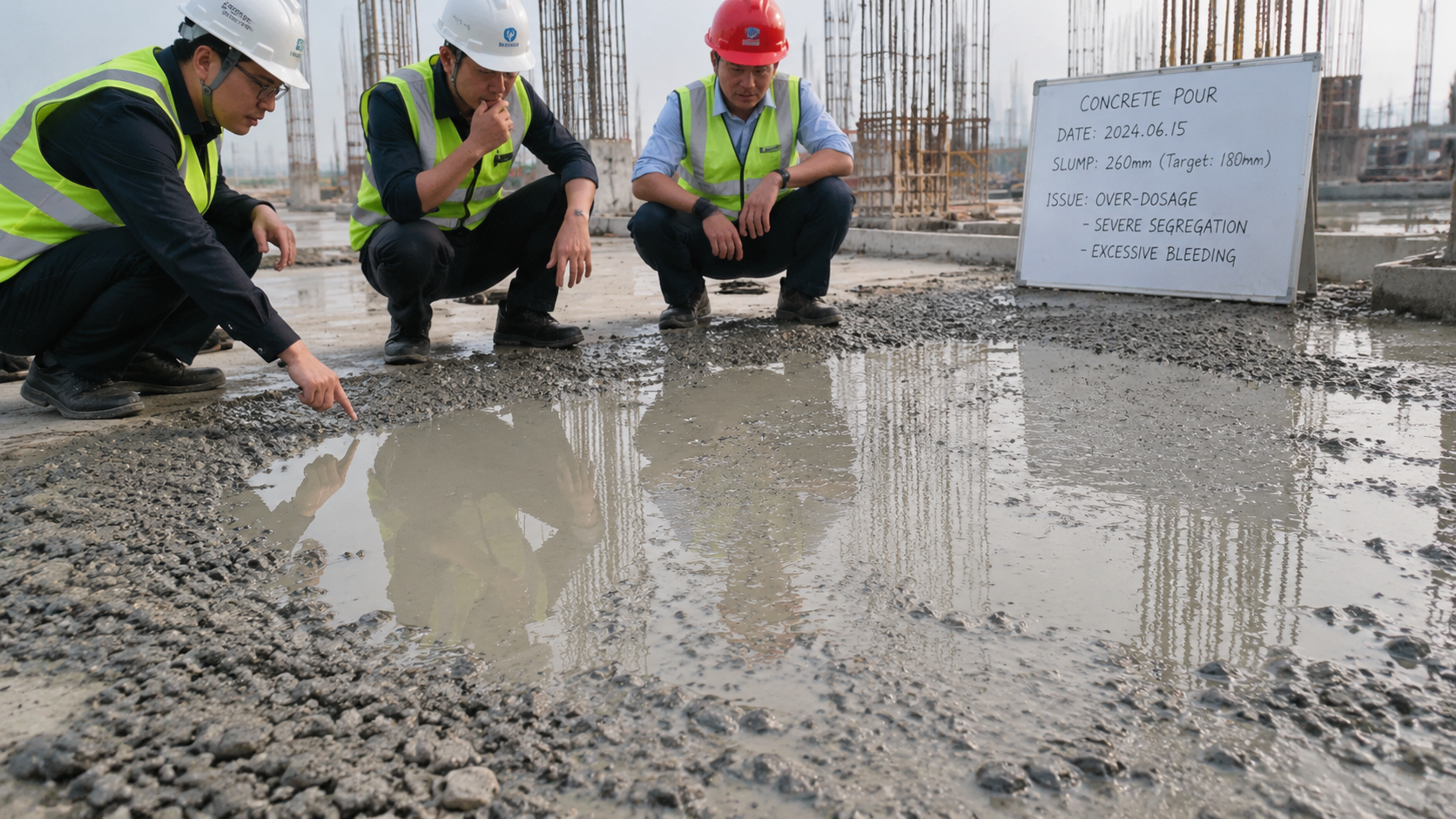

Rapid Bleeding: If deep pools of clear water form on top of the concrete within minutes of placement, the mix is unstable.
If you catch the overdosage early enough (usually while the concrete is still in the mixer truck or shortly after pouring), apply these engineering rescue protocols:
[Emergency Salvage Decision Tree]
├── Detect Overdose in Truck ──> Apply Dry Re-Batching (Add Cement + Aggregates)
├── Delayed Setting (On Site) ──> Inject Hydration Accelerators (Calcium Formate)
└── Excess Macro-Bubbles ───────> Add Defoamers (Air-De-entrainers)
The most effective way to neutralize an overdose is to increase the volume of solid materials.
Calculate the estimated overdose ratio (e.g., if double-dosed, you have twice the chemical concentration).

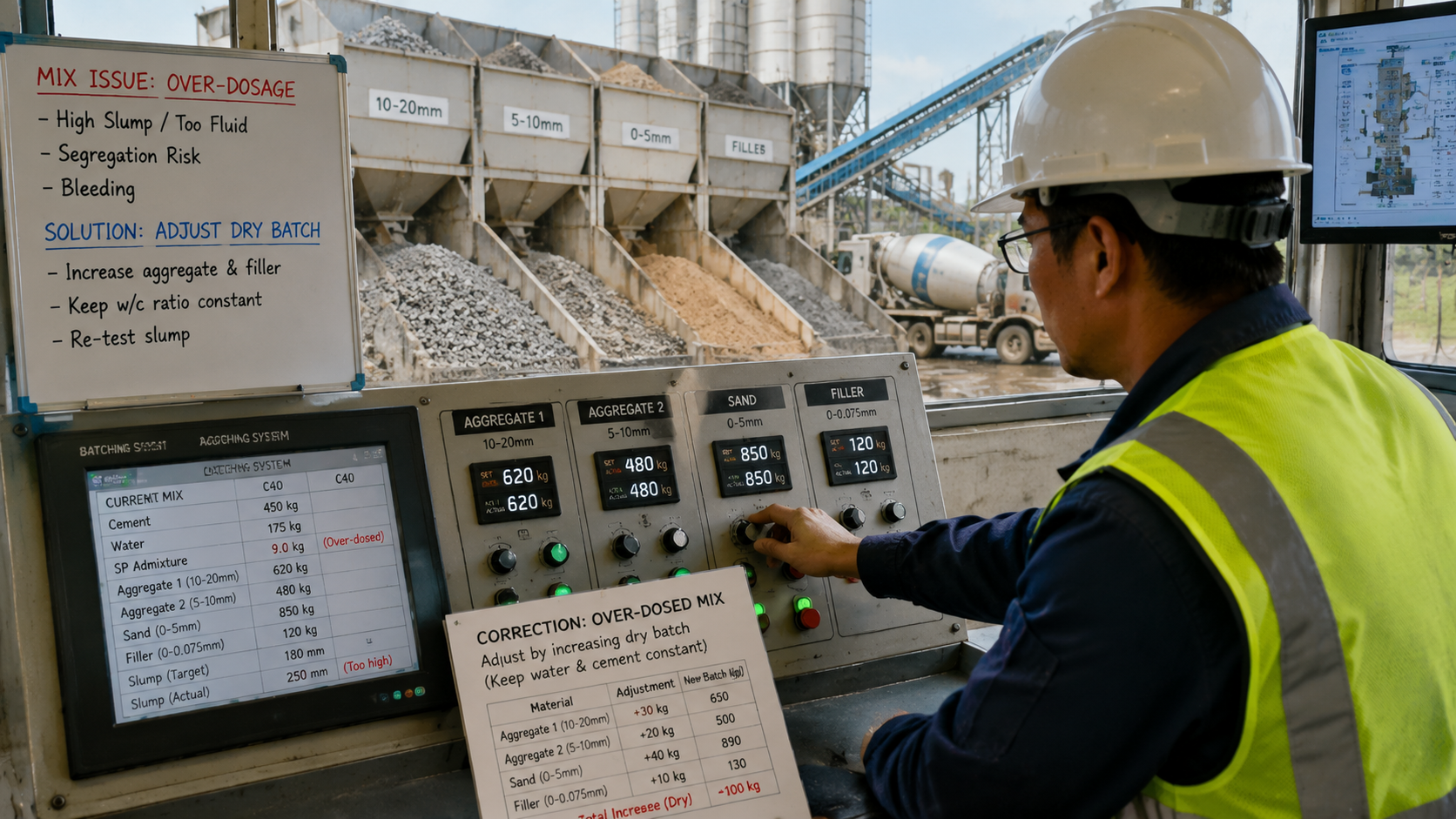

Add a calculated dry batch of cement, sand, and coarse aggregates in their original proportions (without adding water) directly into the transit mixer.
Spin the drum at high speed (12 to 15 rpm) for at least 10 minutes to ensure complete, homogeneous dispersion of the dry materials. This dilutes the relative admixture dosage back to the target percentage.
If the concrete has already been poured and remains in a liquid state for over 12 hours, you must introduce chemical catalysts.
Add calcium formate (for reinforced concrete) or calcium chloride (only for unreinforced concrete to avoid steel corrosion) at a dosage of 0.5% to 1.5% by weight of cement.
This accelerates the dissolution of silicate phases and kickstarts the dormant hydration process.
If the overdose has introduced an excessive volume of unstable macro-bubbles, dose the mix with a commercial silicone-based defoamer or air-de-entrainer (such as concrete air-down agents). This breaks down the weak, large air voids, restoring the density and potential strength of the concrete matrix.
If the over-dosaged concrete has been cast and cannot be removed, you must implement strict curing remediation:
Extend Shuttering/Formwork Time: Do not strip the formwork prematurely. Keep the support structures in place until the concrete passes a rebound hammer test or laboratory cylinder compression test.

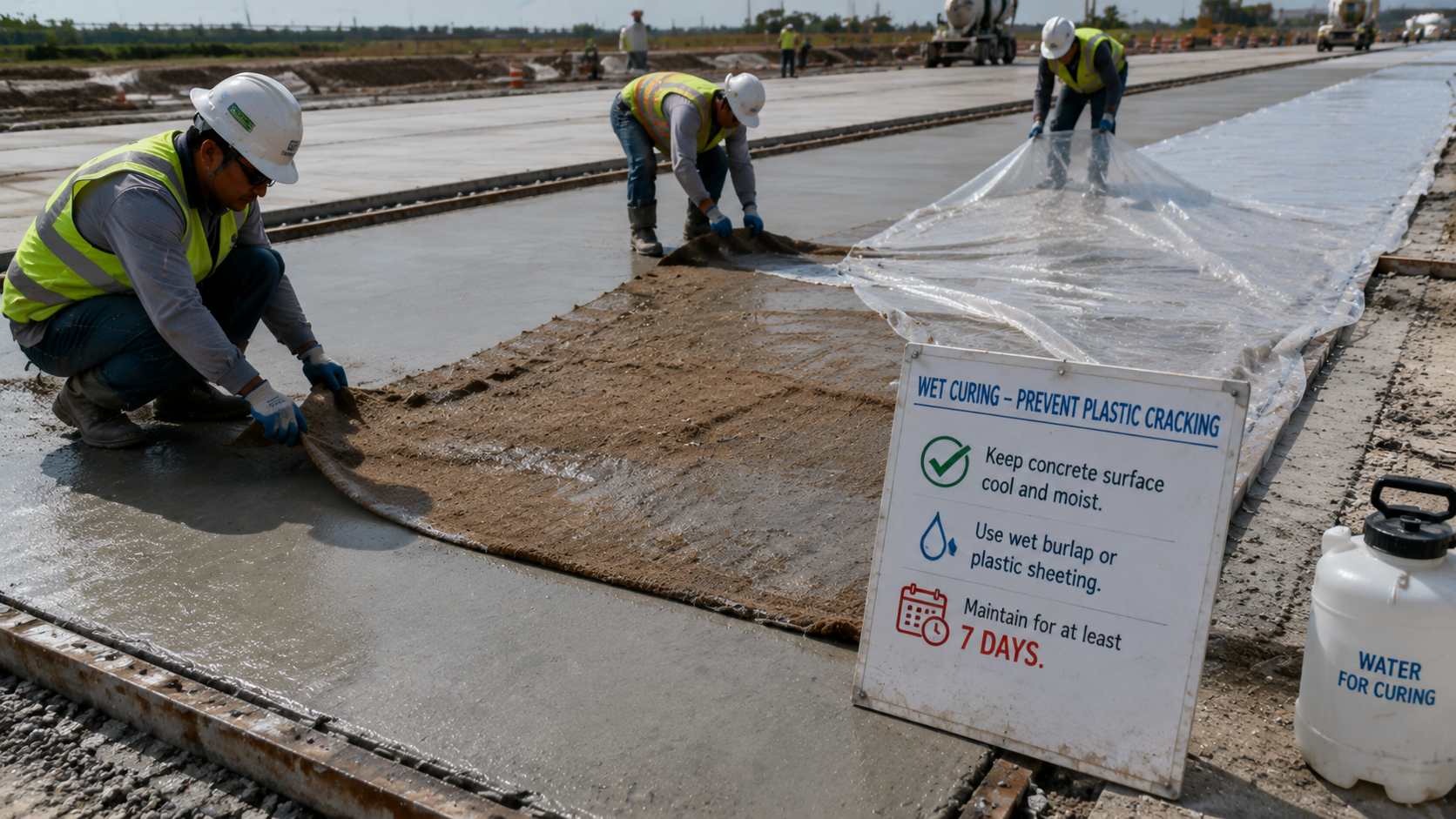

Moist and Warm Curing: Maintain a high-humidity environment (using wet burlap or plastic sheets) and apply heat blankets if temperatures drop. Keeping the concrete warm accelerates cement hydration, helping it overcome chemical retardation.
