How To Effectively Mitigate The Slump Loss of Polycarboxylate Superplasticizers During Hot Weather Construction?
You are here: Home » Blog » Blog » How To Effectively Mitigate The Slump Loss of Polycarboxylate Superplasticizers During Hot Weather Construction?

How To Effectively Mitigate The Slump Loss of Polycarboxylate Superplasticizers During Hot Weather Construction?

Views: 0     Author: Site Editor     Publish Time: 2026-07-21      Origin: Site

Inquire

wechat sharing button
line sharing button
twitter sharing button
facebook sharing button
linkedin sharing button
pinterest sharing button
whatsapp sharing button
sharethis sharing button
How To Effectively Mitigate The Slump Loss of Polycarboxylate Superplasticizers During Hot Weather Construction?

Executive Summary & Direct Answer

How is PCE slump loss mitigated in hot weather concrete construction?

Slump loss of Polycarboxylate Ether (PCE) superplasticizers in hot weather construction is primarily caused by accelerated cement hydration, rapid moisture evaporation, and high initial adsorption kinetics of PCE polymers. It can be effectively mitigated through four synergistic strategies:

  1. Molecular Customization: Blending standard PCE with slow-release (slump-retaining) PCE copolymers featuring long side chains or ester hydrolysis functional groups.

  2. Set Retardation Synergy: Incorporating retarding admixtures such as sodium gluconate, citric acid, or retarder-type PCE formulations to delay initial setting.

  3. Thermal Control Operations: Lowering raw material temperatures using chilled water, ice substitution, or wet aggregate cooling to maintain concrete temperatures below 30°C–32°C.

  4. Delayed Addition Method: Dosing the PCE superplasticizer 30 to 60 seconds after the initial water mixing stage to prevent early competitive adsorption and rapid exhaustion.

What Causes Rapid Slump Loss of PCE Superplasticizers in High Temperatures?

During ambient temperatures exceeding 30°C (86°F), concrete mixtures suffer from rapid workability loss, commonly known as slump loss. While Polycarboxylate Superplasticizers (PCE) represent the gold standard of high-range water reducers (HRWRAs) due to their steric hindrance mechanism, hot weather conditions trigger chemical and physical phenomena that compromise their performance.

High Ambient Temperature (>30°C)
  ├──> Accelerated Hydration (Rapid C3S / C3A Reaction) ──> Rapid PCE Entrapment
  ├──> Accelerated Water Evaporation ─────────────────────> Reduced Free Water
  └──> Increased Initial Adsorption Rate ─────────────────> Premature PCE Depletion

1. Accelerated Cement Hydration Kinetics

High temperatures exponentially speed up the hydration rates of tricalcium aluminate ($C_3A$) and tricalcium silicate ($C_3S$). As hydration products (such as ettringite and C-S-H gel) form rapidly within the first 15–30 minutes, they physically encapsulate the adsorbed PCE molecules, rendering their comb-like side chains incapable of providing steric hindrance.

2. High Moisture Evaporation Rate

Under hot and windy ambient conditions, the evaporation of free mixing water reduces the overall fluid volume of the paste, leading to immediate stiffening and increased yield stress of the fresh concrete mix.

3. Rapid Initial Adsorption of Polymers

At elevated temperatures, standard water-reducing PCE molecules adsorb onto cement grain surfaces too aggressively during the first few minutes. This initial over-consumption leaves insufficient polymer molecules remaining in the pore solution to maintain dispersion over a 1 to 2-hour transit window.

How Does Hot Weather Impact PCE Molecular Performance?

Environmental Factor

Physical Mechanism

Impact on PCE Dispersion

Impact on Concrete Workability

High Temperature (>32°C)

Thermal degradation / side chain coil collapse

Reduced steric hindrance radius

Rapid slump drop (50–100 mm loss in 30 min)

Low Relative Humidity (<50%)

High surface moisture loss

Decreased continuous phase volume

Early crusting, bleeding, or flash setting

High Wind Speed (>15 km/h)

Accelerated surface evaporation

Depletion of free water in pore solution

High risk of plastic shrinkage cracking

High Cement Temperature (>60°C)

Rapid initial $C_3A$ hydration phase

Massive early PCE adsorption and burial

Immediate loss of initial fluidity

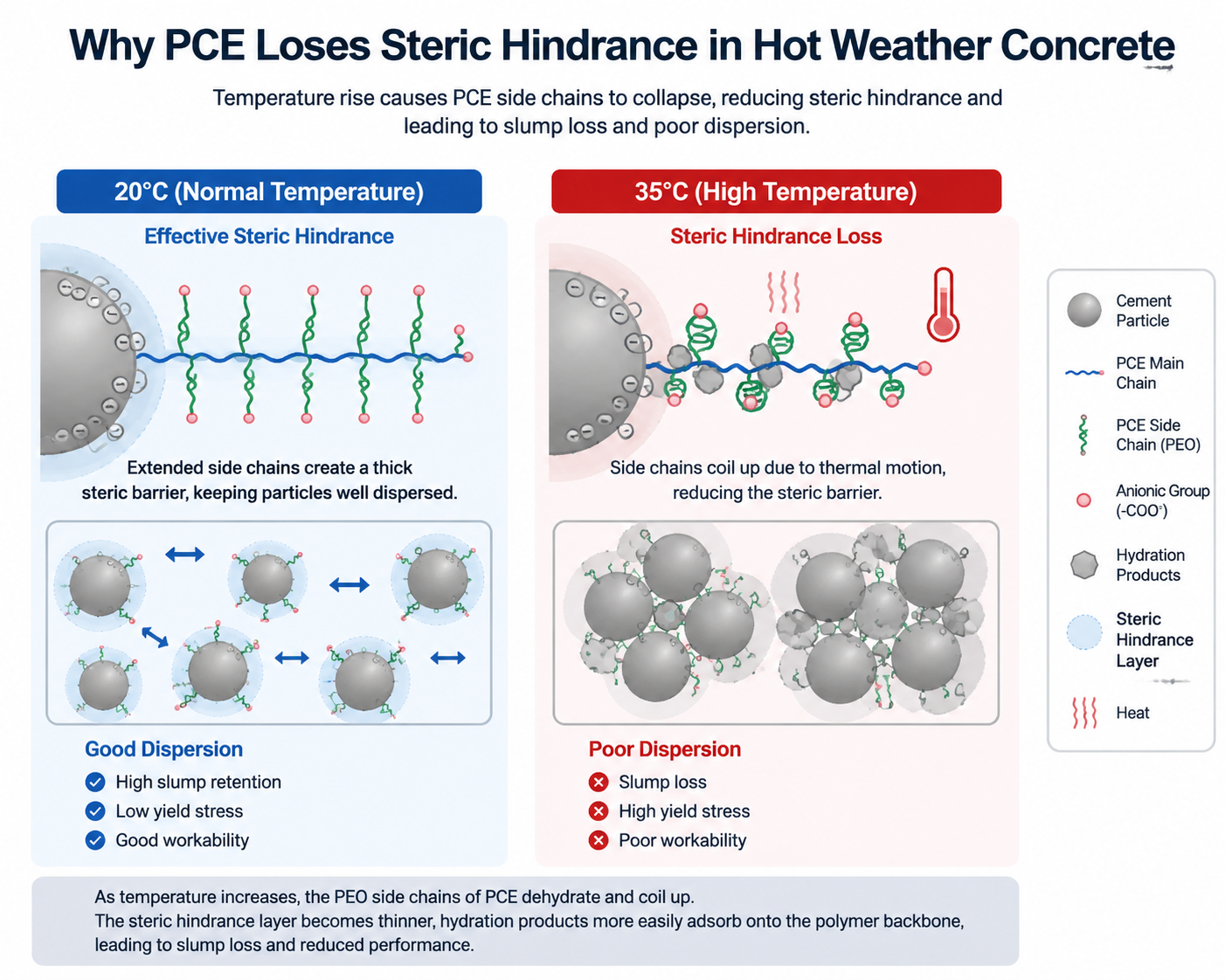

Diagram of Polycarboxylate Superplasticizer steric hindrance loss in hot weather concrete.png

Alt Tag: Diagram of Polycarboxylate Superplasticizer steric hindrance loss in hot weather concrete.

What Chemical Strategies Mitigate PCE Slump Loss in Hot Weather?

To guarantee long-distance pumping and extended placement times during summer, chemical modification of the admixture blend is the most powerful tool available to concrete technologists.

           PCE Slump Retention Chemical Strategy
                           │
      ┌────────────────────┴────────────────────┐
      ▼                                         ▼
Slow-Release PCE (Ester Type)          Set-Retarding Admixtures
- Cleaves ester groups in alkaline pH    - Extends induction period
- Continuous release of dispersion       - Inhibits early C3A/C3S hydration
- Maintains 2+ hours slump retention     - Prevents flash setting

1. Utilizing Slow-Release (Slump-Retaining) PCE Copolymers

Standard water-reducing PCEs (methacrylic acid / macromonomer esters) offer high early dispersion but poor retention. In contrast, slow-release PCEs feature ester-based functional groups (e.g., acrylate esters). Under the highly alkaline environment ($pH > 12.5$) of fresh cement paste, these ester groups undergo gradual hydrolysis over 30 to 120 minutes.

As hydrolysis proceeds, new carboxylic acid groups ($-COOH$) are continuously generated, releasing fresh dispersion capability over time to replenish lost workability.

  • Recommended Ratio: Blend 60%–70% Standard High-Reduction PCE + 30%–40% Slow-Release PCE.

2. Incorporating Retarding Admixtures

Combining PCE with retarding agents lowers early hydration heat peaks and delays the formation of ettringite crystals:

  • Sodium Gluconate: Dosage of 0.03%–0.08% by weight of cementitious materials. Provides predictable retarding effects without compromising 28-day compressive strength.

  • Citric Acid / Tartaric Acid: Highly effective organic hydroxycarboxylic acids for extreme heat (>38°C).

  • Sugar / Maltodextrin: Cost-effective options when balanced carefully against early strength requirements.

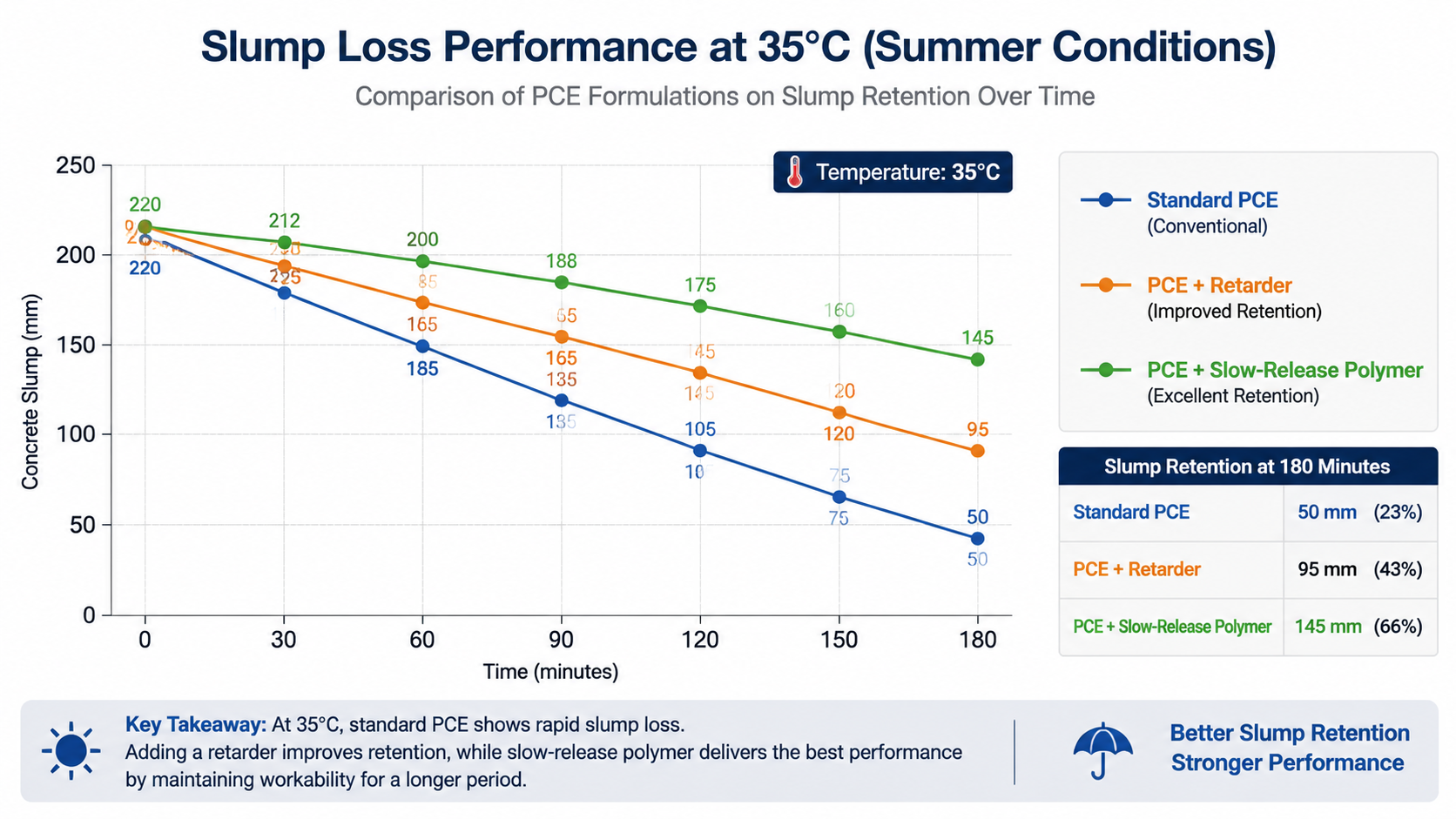

Concrete slump loss retention curves comparing different PCE formulations in summer conditions..png

Alt Tag: Concrete slump loss retention curves comparing different PCE formulations in summer conditions.

What Operational and Mix Design Measures Should Be Implemented?

Chemical additives alone cannot overcome improper site practices. Engineering teams must enforce rigorous hot-weather concrete guidelines (such as ACI 305R):

Step-by-Step Operational Mitigation Checklist

  1. Control Concrete Discharge Temperature:

    • Keep fresh concrete temperature below 30°C–32°C.

    • Replace up to 30%–50% of batching water with flaked ice.

    • Aggregate shade canopy usage and continuous evaporative cooling (water spraying on coarse aggregate piles).

  2. Adopt the Delayed PCE Addition Method:

    • Adding PCE together with dry cement causes excessive early adsorption.

    • Best Practice: Add 70%–80% of batching water first, mix for 15–30 seconds, and then inject the PCE liquid with the remaining water. This increases dispersion efficiency by 15%–20% and improves slump retention.

  3. Optimize Mineral Admixtures (SCMs):

    • Replace 20%–30% of Portland cement with Fly Ash (Class F) or Ground Granulated Blast-Furnace Slag (GGBFS).

    • SCMs reduce overall heat of hydration, lower $C_3A$ concentration, and drastically decrease the initial PCE absorption demand.

  4. On-Site Re-dosing Protocol:

    • If slump drops unexpectedly at the job site prior to discharge, re-dose a specialized PCE Slump Reconditioner Liquid directly into the transit mixer drum at 0.1%–0.3% dosage, mixing at top speed for 30 revolutions (or minimum 3 minutes).

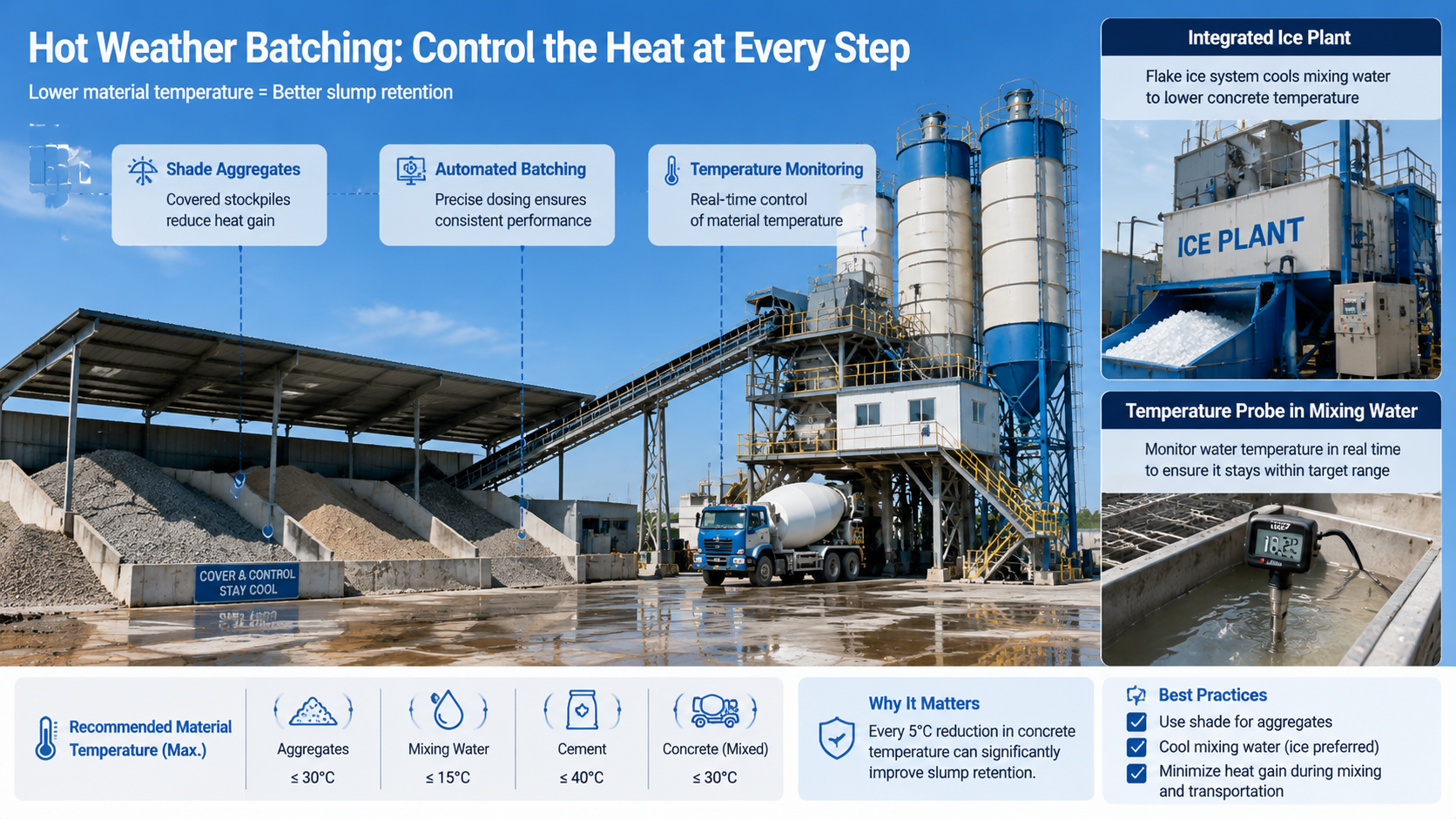

Hot weather concrete batching plant with ice cooling system for slump loss control.png

Alt Tag: Hot weather concrete batching plant with ice cooling system for slump loss control.

Frequently Asked Questions (FAQ)

Q1: Why does adding more water to restore slump in hot weather ruin concrete quality?

Adding re-temper water at the jobsite increases the water-cement ratio ($w/c$), leading to a severe drop in compressive strength (a 10 mm increase in slump via water can reduce strength by 2–5 MPa), increased drying shrinkage, higher permeability, and reduced long-term durability. Always use PCE re-dosing instead of water.

Q2: What is the ideal dosage of Polycarboxylate Superplasticizer in high-temperature conditions?

While typical PCE solid content dosages range from 0.15% to 0.35% by weight of cementitious materials (or 0.8%–1.5% liquid dosage at 20% solid content), hot weather conditions may require a 10%–20% increase in total dosage, leaning towards higher proportions of retarding/slump-retaining components.

Q3: How do I choose between retarding-type PCE and standard PCE + separate sodium gluconate?

  • Factory-Blended Retarding PCE (e.g., Qiandao SY-PA Retarding Type): Best for ready-mix batch plants seeking consistent quality control, zero manual dosing errors, and optimized molecular stability.

  • On-Site Dual Dosing: Useful when ambient temperatures fluctuate wildly between night and day, allowing batch managers to adjust retarder dosage dynamically.

Q4: Can clay content in aggregates worsen PCE slump loss in high temperatures?

Yes. Methylene Blue (MB) values exceeding 1.4 indicate high clay (montmorillonite) content. Clay minerals aggressively absorb PCE molecules into their interlayer structures. Elevated temperatures accelerate this intercalation process, causing immediate workability collapse. Use clay-resisting sacrificers (such as sodium hexametaphosphate or specific sacrificial polymers) if high MB aggregates must be used.

Concrete slump cone test evaluating workability retention in hot weather construction..png

Alt Tag: Concrete slump cone test evaluating workability retention in hot weather construction.

Technical Comparison: Standard PCE vs. Retarding/Slump-Retaining PCE

Specification Metric

Standard High-Range PCE

Retarding / Slump-Retaining PCE Blend

Testing Method / Standard

Water Reduction Rate (%)

>= 27%

>= 25%

GB 8076 / ASTM C494 Type F/G

1-Hour Slump Retention Loss (mm)

50 – 90 mm loss

<= 20 – 30 mm loss

GB 8076 / ASTM C143

Initial Setting Time Difference (min)

-30 to +90 min

+120 to +300 min

ASTM C403 / GB 8076

28-Day Compressive Strength Ratio (%)

>= 150%

>= 140%

GB 8076 / ASTM C39

Primary Application

Precast elements, early strength concrete

Ready-mix, mass concrete, hot weather pumping

Civil engineering projects

As a leading supplier of construction materials in China, we possess a professional sales team, extensive supplier resources, deep market roots, and exceptional one-stop services.

CONTACT US

Phone:+86-158-7144-7376
Email:qianlanxiao394@gmail.com
Add:Zelin Village, Lion Mountain,Zelin Town, Echeng District, Ezhou City, Hubei Province,China

QUICK LINKS

PRODUCTS CATEGORY

SIGN UP FOR OUR NEWSLETTER

Copyright © 2026 Hubei Qiandao New Materials Co., Ltd.  All Rights Reserved.| Sitemap
